Technical HDD
The record

Rig classes

Thirteen numbered rigs in five classes, each fielded as a complete package — machine, navigation, fluid and solids control, tooling and support. Two of the five classes were machines built in the group's own shop rather than bought.

ClassRigsMachinePush / pullRotary torqueDrill pipe
20-ton10 · 11Vermeer D36x5036,000 lb5,000 ft-lb2.625″
50-ton20 · 21 · 22Vermeer D100x120 Series II100,000 lb12,000 ft-lb20′ × 3.5″
100-ton30 · 31 · 32Tech HD 200x250 — built in house200,000 lb25,000 ft-lb20′ × 3.5″
175-ton40 · 41 · 42Tech HD 330x500 — built in house330,000 lb50,000 ft-lb5″ G105
375-ton50 · 51Vermeer D750x900750,000 lb90,000 ft-lb5.5″ G105

What went with each machine

A rig is not a spread. Each class was fielded with a navigation package, a fluid and solids-control train sized to the hole volume, a tooling set matched to the formations it would see, and the support fleet that keeps all of it turning — water trucks, tool-crib trailers, crew trucks and environmental response units.

  • Navigation. Walkover guidance with satellite positioning across all classes, with a logging tool and an annular pressure transmitter; wireline steering added from the 50-ton class up.
  • Fluids and solids. Desanding and desilting to a fine cut with linear shakers through the mid fleet; dual scalping shakers and high-capacity centrifuges on the 175- and 375-ton spreads.
  • Tooling. Jetting assemblies for tills and clays, motors and down-hole hammers for rock, and reamer sets from 8 to 60 inches depending on class.
  • Fleet management. Real-time positioning on all in-field equipment.

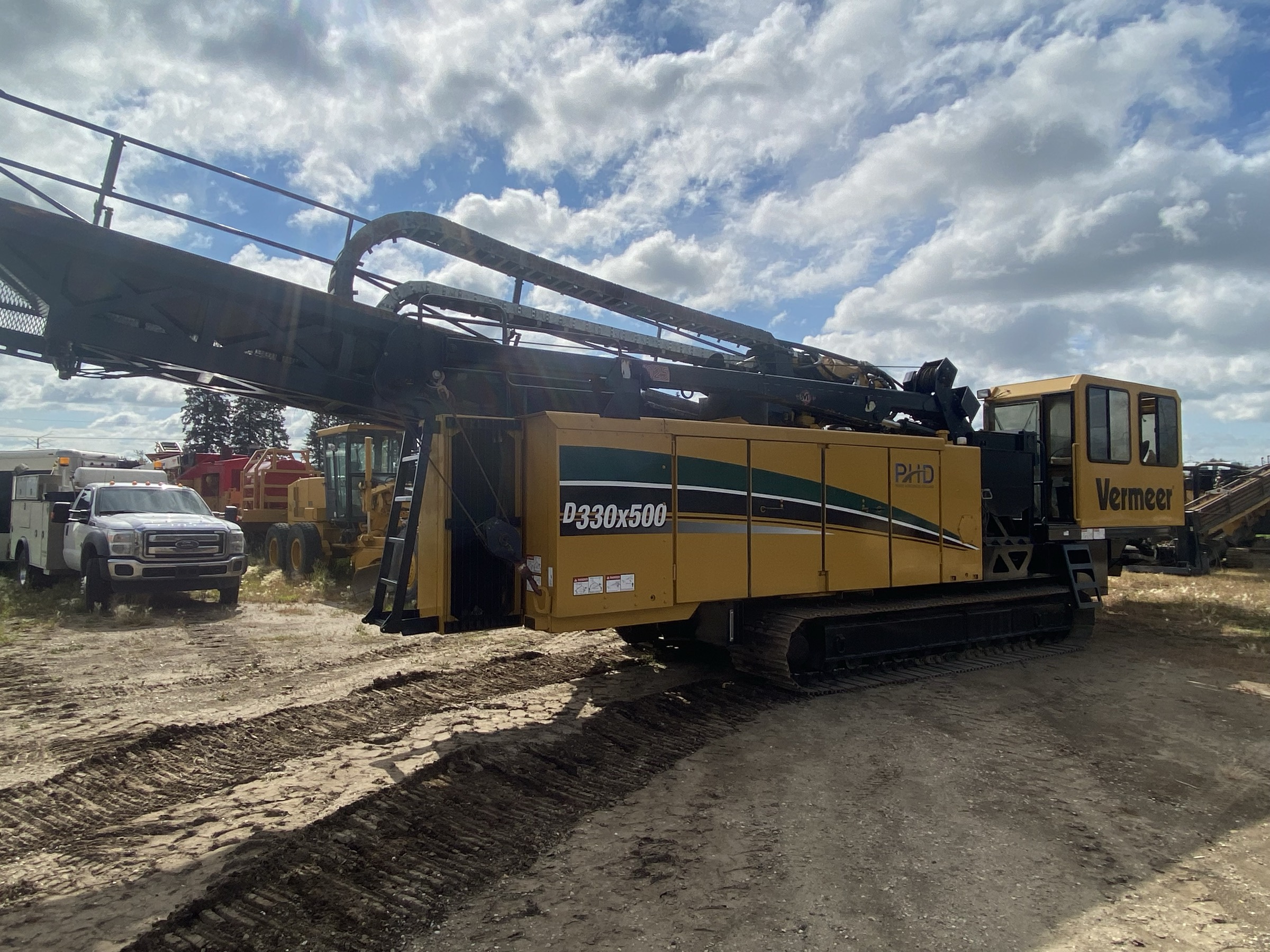

A Vermeer D330x500 directional drill in a yard, drill frame lowered, side view
The 175-tonne class

Three hundred and thirty thousand pounds of pull, and the pipe will take two hundred.

This is the mismatch at the centre of most lost pullbacks. The rig's rating and the product's allowable are different numbers, and the rig's is almost always the bigger one.

Somebody has to own the limit that actually matters, write it on the drill plan, and tell the driller what it is.

Site footprint by class

The thing most often underestimated at planning stage. The spread has to fit on ground you control, at both ends.

20 × 10 m20-ton spread
 rising through the classes
45 × 45 m375-ton maxi spread
5–8 mworking corridor between set-ups
Why a consultancy publishes this

Because the commonest equipment error we see is a class mismatch — a rig too small for the computed pull, or a maxi rig mobilised for a job a mid-class machine would do faster and cheaper. Knowing what each class actually needs around it, and what footprint it lands on, is the difference between a spread that works and one that is waiting on water trucks.
